Portugal’s January-April PV installations hit 118 MW – pv magazine International

Published:


Regardless of the gradual begin to the 12 months, BloombergNEF expects Portugal to put in one other 1,363 MW of photo voltaic by the tip of 2023. The chance of that situation appears to come back right down to how rapidly initiatives from record-breaking 2019- 20 photo voltaic auctions will go browsing, in the event that they do.

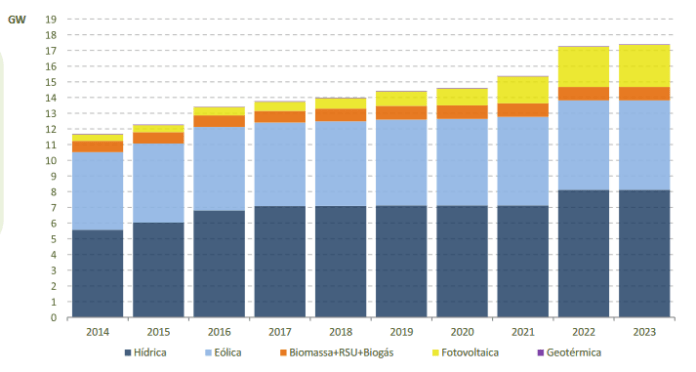

The newest statistics from Portugal’s Directorate Basic for Vitality and Geology (DGEG) present that the nation added simply 118 MW of latest photo voltaic capability within the first 4 months of 2023.

Regardless of a gradual begin to the 12 months, new photo voltaic installations in Portugal could have gained momentum in Could and June, mirroring the development from final 12 months. From January to April 2022, Portugal added solely 111 MW, however in Could, it noticed a rise of 262 MW, bringing the full to 373 MW. In June, an extra 173 MW have been put in, bringing the full to 546 MW. Nonetheless, the second half of the 12 months skilled slower progress, with 344 MW of latest additions.

BloombergNEF predicts that photo voltaic installations in Portugal will attain 1,363 MW by the tip of 2023, a big improve in comparison with final 12 months’s 890 MW and the present 118 MW of latest capability. The analysis supplier estimates that Portugal will add 1,632 MW in 2024, 1,749 MW in 2025, and 1,741 MW in 2026. From 2030 onwards, BNEF initiatives comparatively steady annual installations of round 1,745 MW.

The 2026 cut-off for the rise of annual installations is noteworthy: that is the commissioning deadline for the winners of the record-breaking Portuguese photo voltaic auctions from 2019 and 2020. That’s if the deadline will not be returned once more. In February of this 12 months, Portugal launched longer deadlines for a number of phases of the venture commissioning course of. The nation’s vitality secretary, Ana Fontoura Gouveia, recognized the worldwide instability brought on by Russia’s invasion of Ukraine because the trigger and warned that additional extensions wouldn’t be dominated out if the battle continued.

Gradual progress in record-breaking photo voltaic public sale initiatives, however, is probably going a key issue behind the slowdown in new capability additions in Portugal. From the 2019 public sale, solely seven of the 25 PV crops are working. No venture from the 2020 public sale has been accomplished to this point. The 2019 public sale allotted 1,150 MW of grid capability, with the 2020 public sale allocating 670 MW, totaling 1,820 MW throughout the 2 auctions.

French developer Akuo received a venture with a photo voltaic tariff of €0.0147 ($0.014)/kWh within the 2019 public sale. This marked a brand new world report at the moment. In 2020, the report was damaged once more, with a profitable bid of $0.0132/kWh.

In October 2022, the Portuguese authorities provided a rise in compensation to the winners of those auctions, which proved unbankable amid rising inflation and tools costs. The brand new legislation additionally introduces a 12-month grace interval throughout which chosen initiatives can promote electrical energy on the spot market worth, as an alternative of the given tariff.

Plainly these steps will not be sufficient to persuade the public sale winners to convey their initiatives on-line. Solely 5% of the nominal energy offered within the 2019 and 2020 auctions was on-line in mid-March, in line with information from Portugal’s Ministry of Environmental and Local weather Motion analyzed by the monetary newspaper. The Financial Journal. Of this 92 MW injected into the grid, Prodigy Orbit, owned by Spanish Solaria, has developed 4 initiatives with a capability of 49 MW. Iberdrola has two PV crops in operation, with 20 MW and 10 MW capability. Lastly, Made Higher, a subsidiary of the Portuguese Grupo Lusiaves, has a 13 MW set up related to the grid.

The brand new deadlines for commissioning initiatives from the 2019 public sale are April 2024 and April 2025, relying on whether or not the initiatives require environmental approval. Photo voltaic initiatives occupying surfaces of lower than 100 hectares are exempt from environmental approval, excluding initiatives in protected areas. The deadlines for the 2020 public sale initiatives are June 2025 and 2026.

The biggest photo voltaic plant within the 2019 public sale belongs to the French of Akuo, with numerous 150 MW, 120 MW, and 100 MW. There are three different initiatives which are over 100 MW in measurement. Within the 2020 public sale, the biggest plant went to Qcells with 109 MW. Spain’s Endesa and Iberdrola have initiatives with 99 MW and 69 MW, respectively.

If the nation installs 1,363 MW by the tip of the 12 months, as predicted by BNEF, a big a part of the initiatives that received the public sale report ought to go browsing, rapidly.

The image may look brighter within the coming years, with large-scale PPA and service provider initiatives scheduled to come back on-line from 2024. Iberdrola and Prosalia, for instance, have already acquired environmental allow from the Portuguese authorities to construct a 1.2 GW photo voltaic plant within the metropolis of Santiago de Cacém. It’s anticipated to begin industrial operation in 2025 and is about to grow to be the biggest PV venture in Europe.

This content material is protected by copyright and might not be reused. If you wish to cooperate with us and wish to reuse a few of our content material, please contact: [email protected].



Source link
